Made in America Manufactured in LeRoy, West Virginia
Call us: 304-344-9875

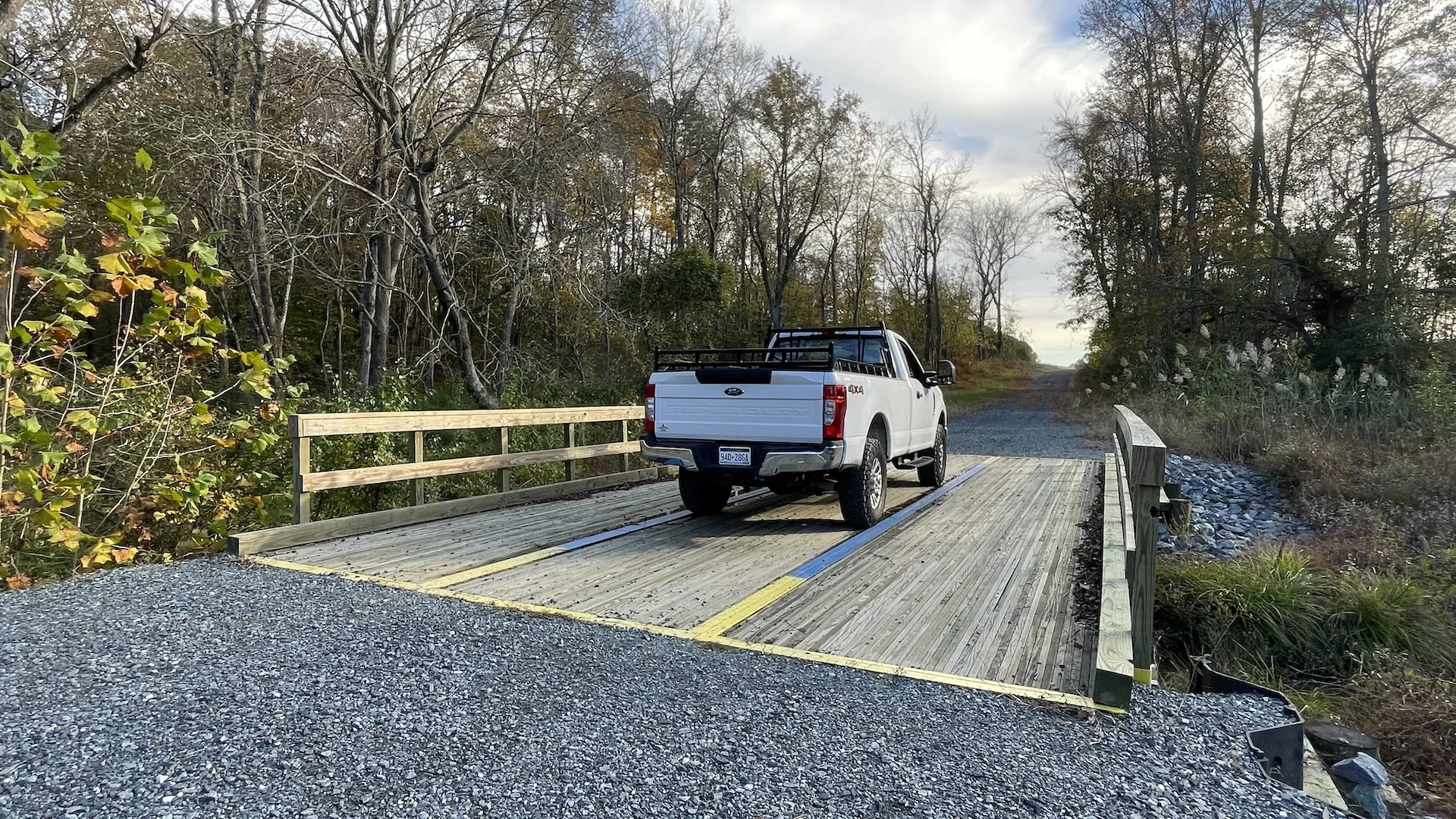

Pickup truck crossing an E&H timber bridge on a rural road
Pre-Engineered • Prefabricated • Made in the USA

Your Stream Crossing.
Installed in Hours,
Not Months.

Pre-engineered stress-laminated timber bridges, delivered ready to install. Rated up to 80,000 lbs. No crane required. Skip the months of permitting, engineering, and on-site construction.

80,000 lb
Max Load Rating
30 & 40 ft
Standard Lengths
< 1 Day
Typical Install

Crossing a stream shouldn't stall your entire project.

Traditional bridge construction means months of delays, complex permits, specialized engineering, and heavy equipment you may not have. There's a better way.

Project Delays

Traditional crossings can take weeks or months to engineer and construct. Your crews, equipment, and revenue sit idle waiting for access.

Permitting Headaches

Navigating federal, state, and local stream crossing permits is expensive and time-consuming. Prefabricated bridges dramatically simplify the process.

Escalating Costs

Custom engineering, site construction, crane mobilization, and specialized labor add up fast. Every week of delay costs you more money.

Environmental Risk

In-stream construction disturbs riverbeds, erodes banks, and creates compliance exposure. A prefab bridge minimizes site disturbance entirely.

One call. Four steps. You're crossing.

Each bridge ships as two modular deck panels on a standard flatbed. Your crew handles installation with equipment already on site.

1

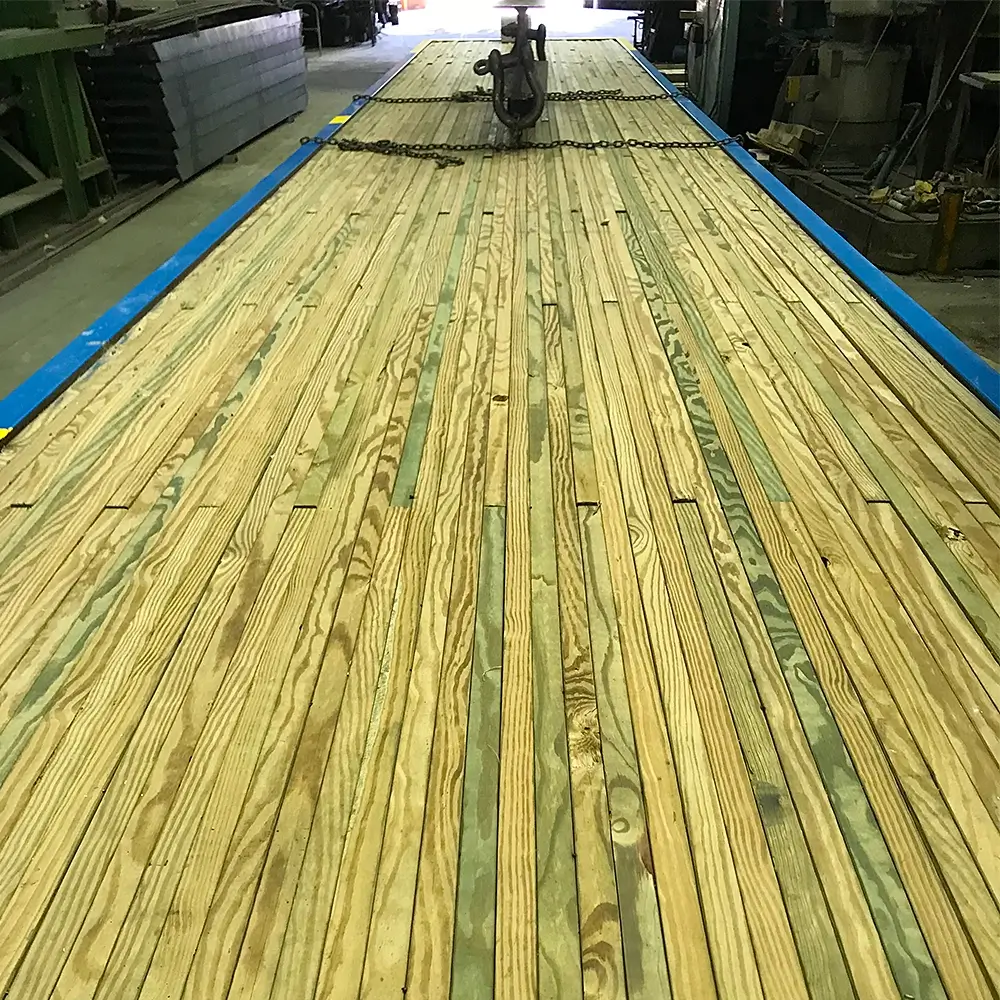

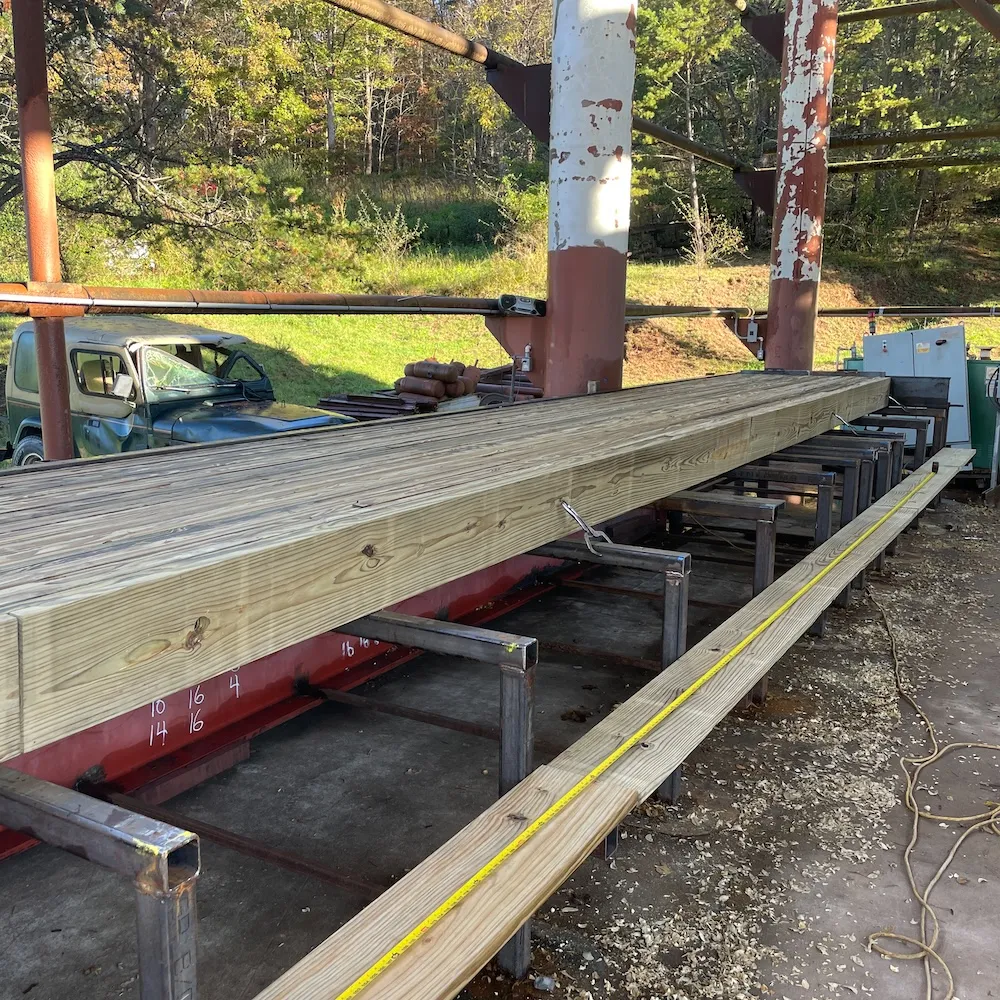

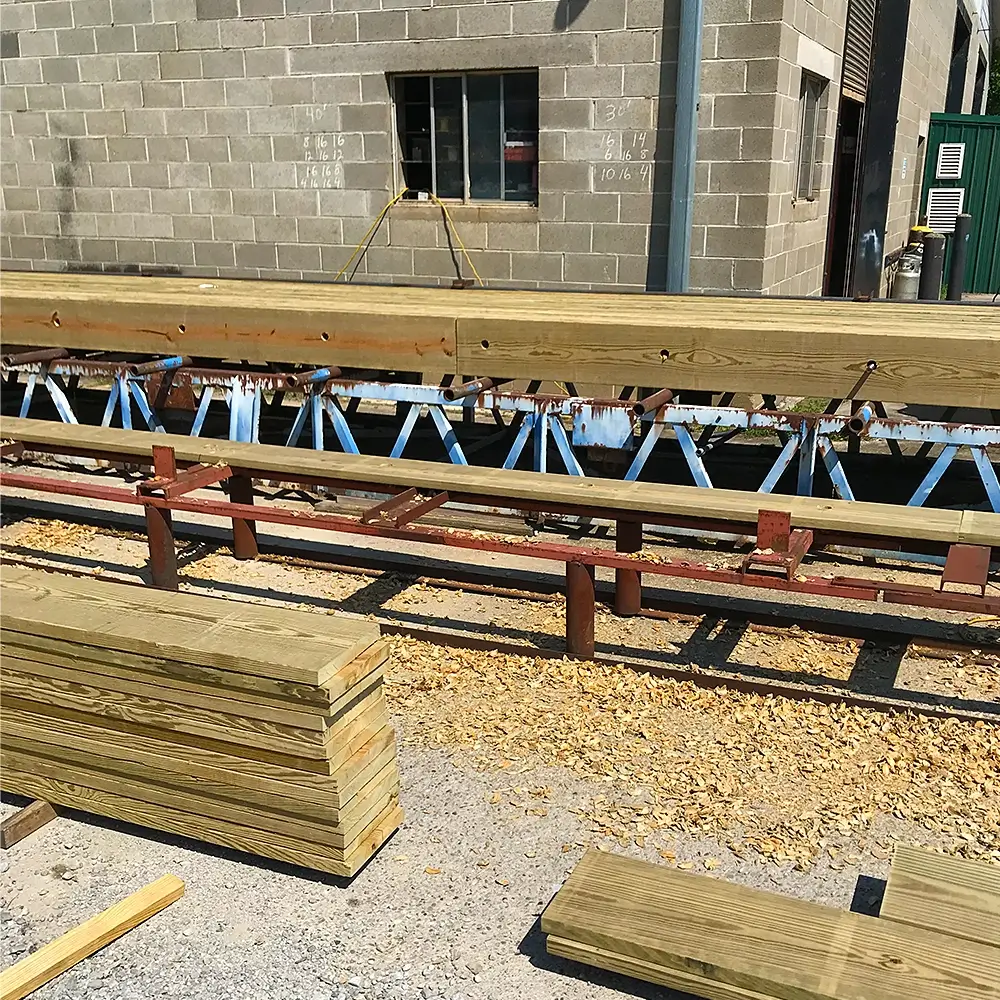

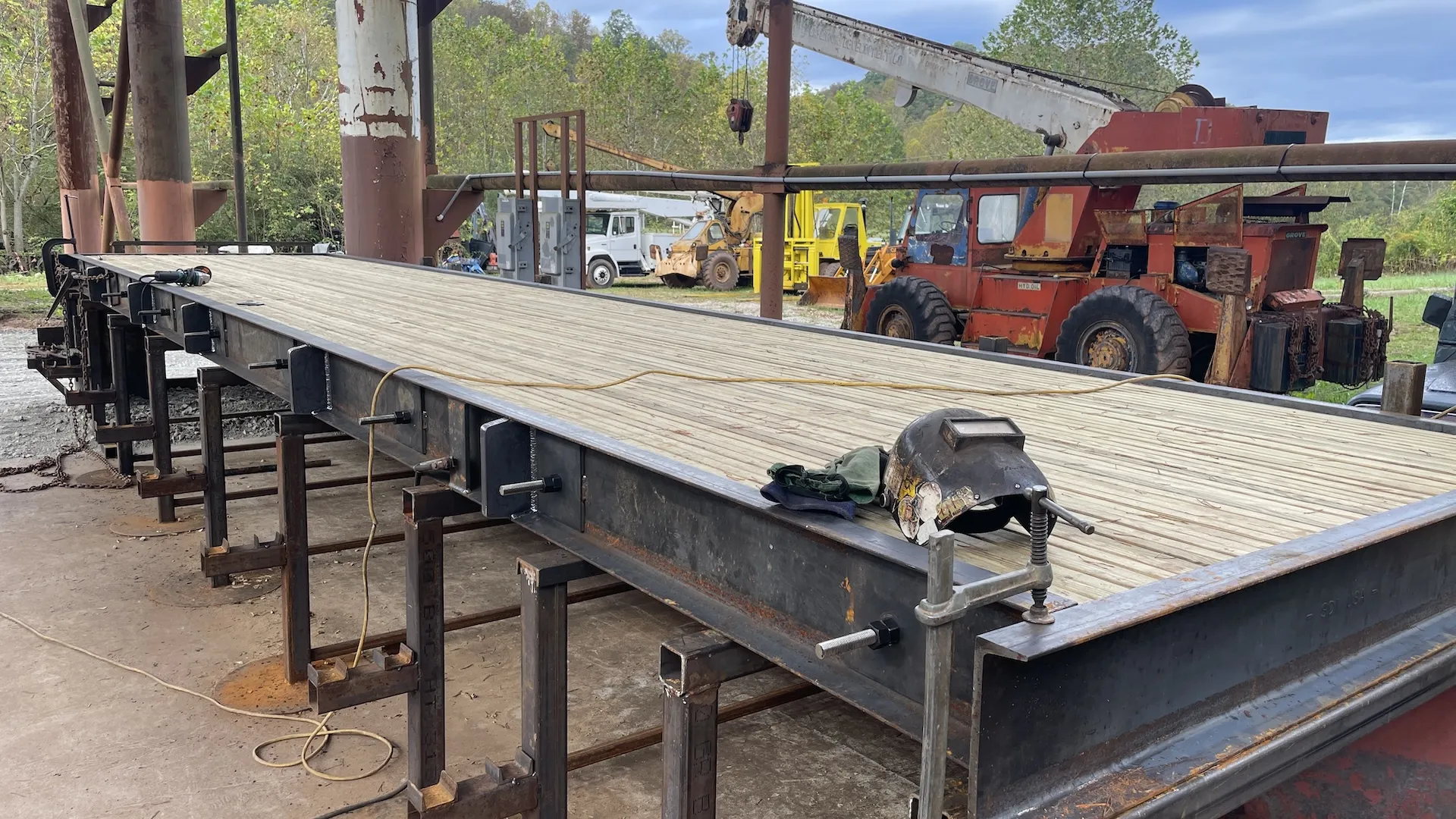

Bridge panel being manufactured
We Build It

Your bridge is pre-engineered and fabricated at our facility in LeRoy, WV. Stress-laminated, steel-reinforced, and load-certified before it ships.

2

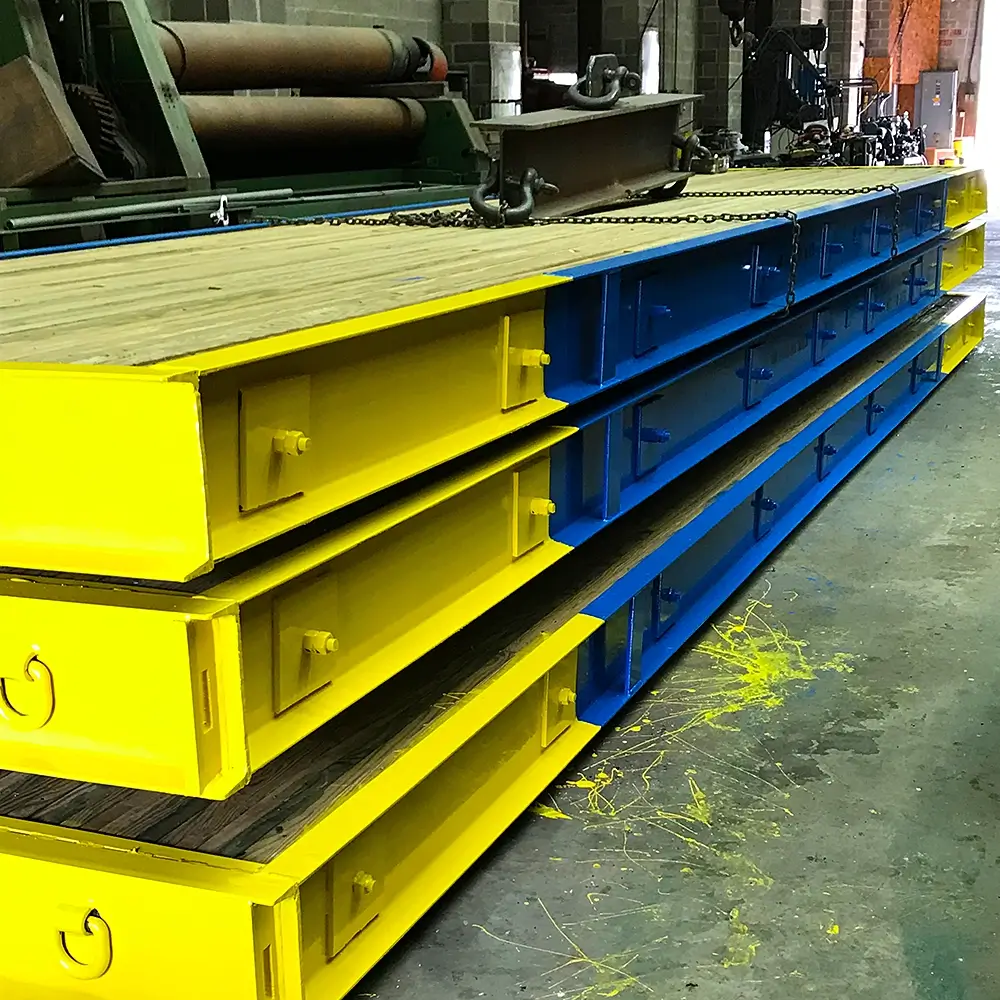

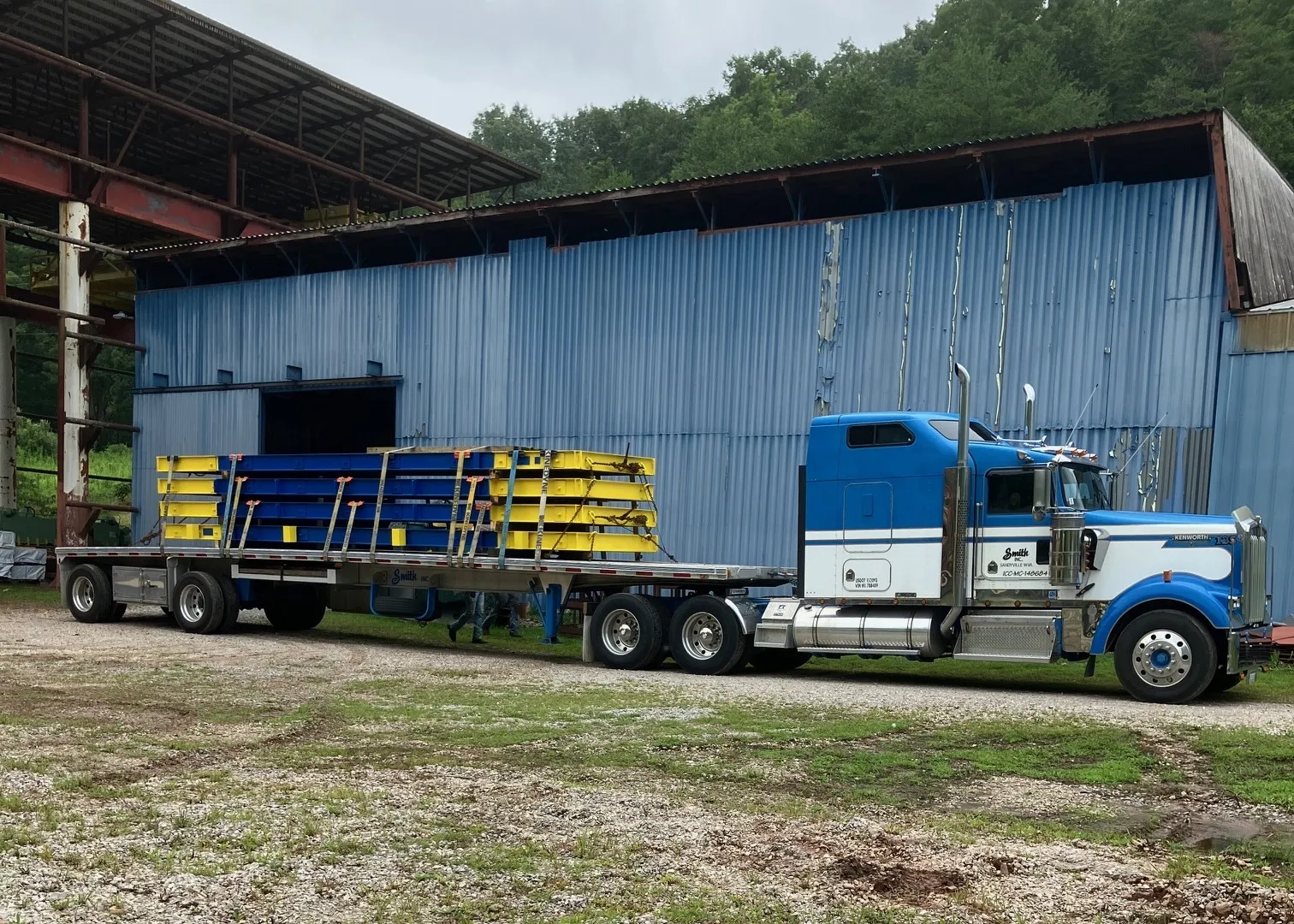

Bridge panels loaded on flatbed trailer
It Gets Delivered

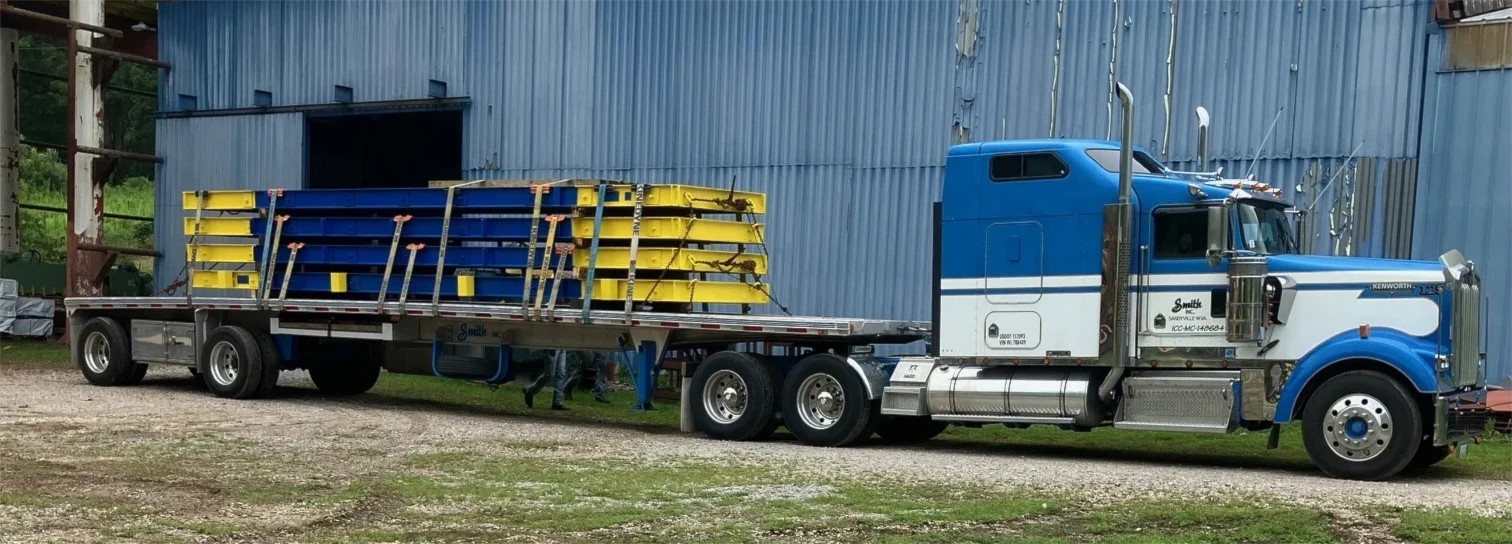

Two deck panels ship stacked on a standard tractor-trailer, FOB our facility. No oversized load permits required.

3

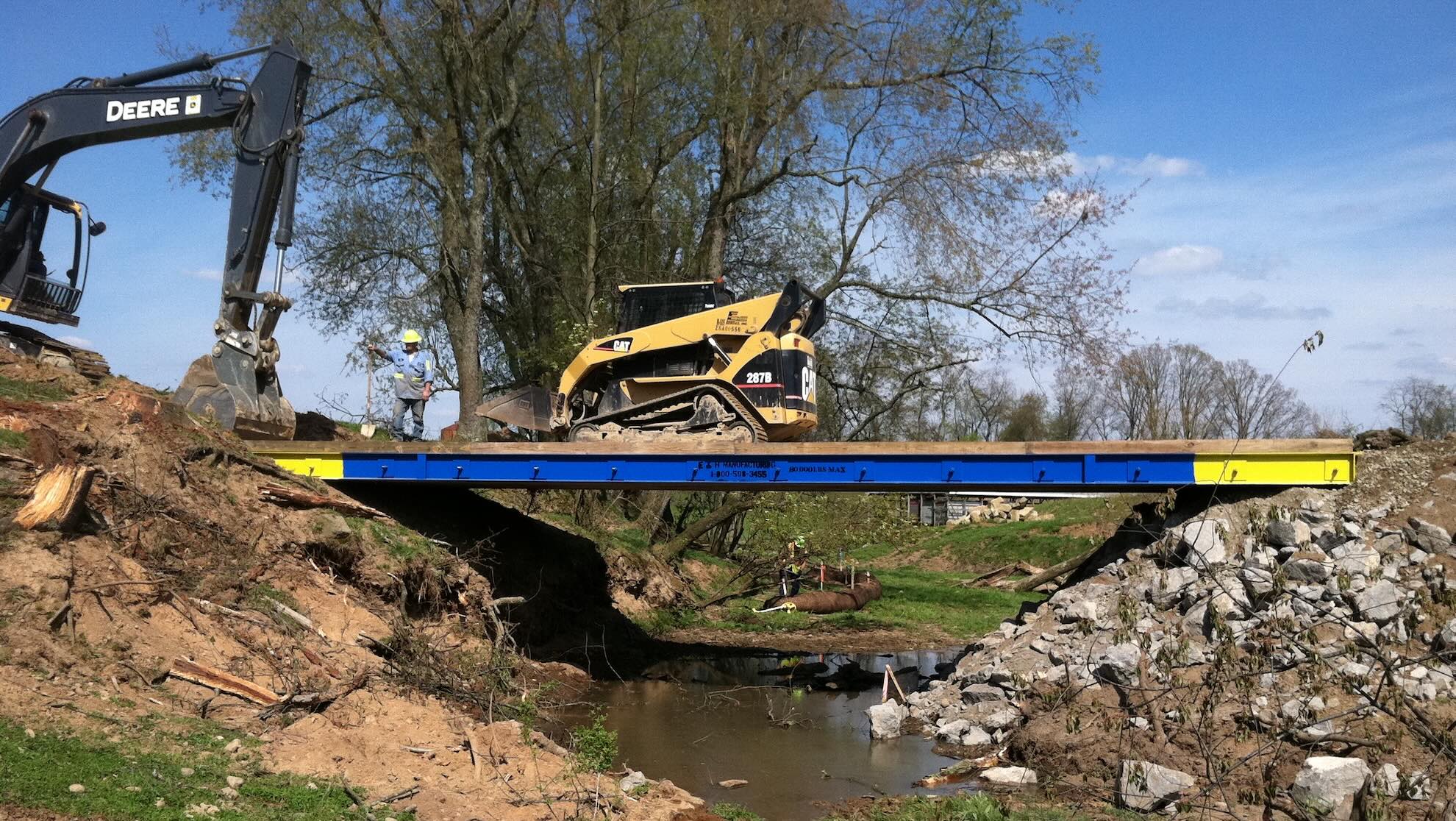

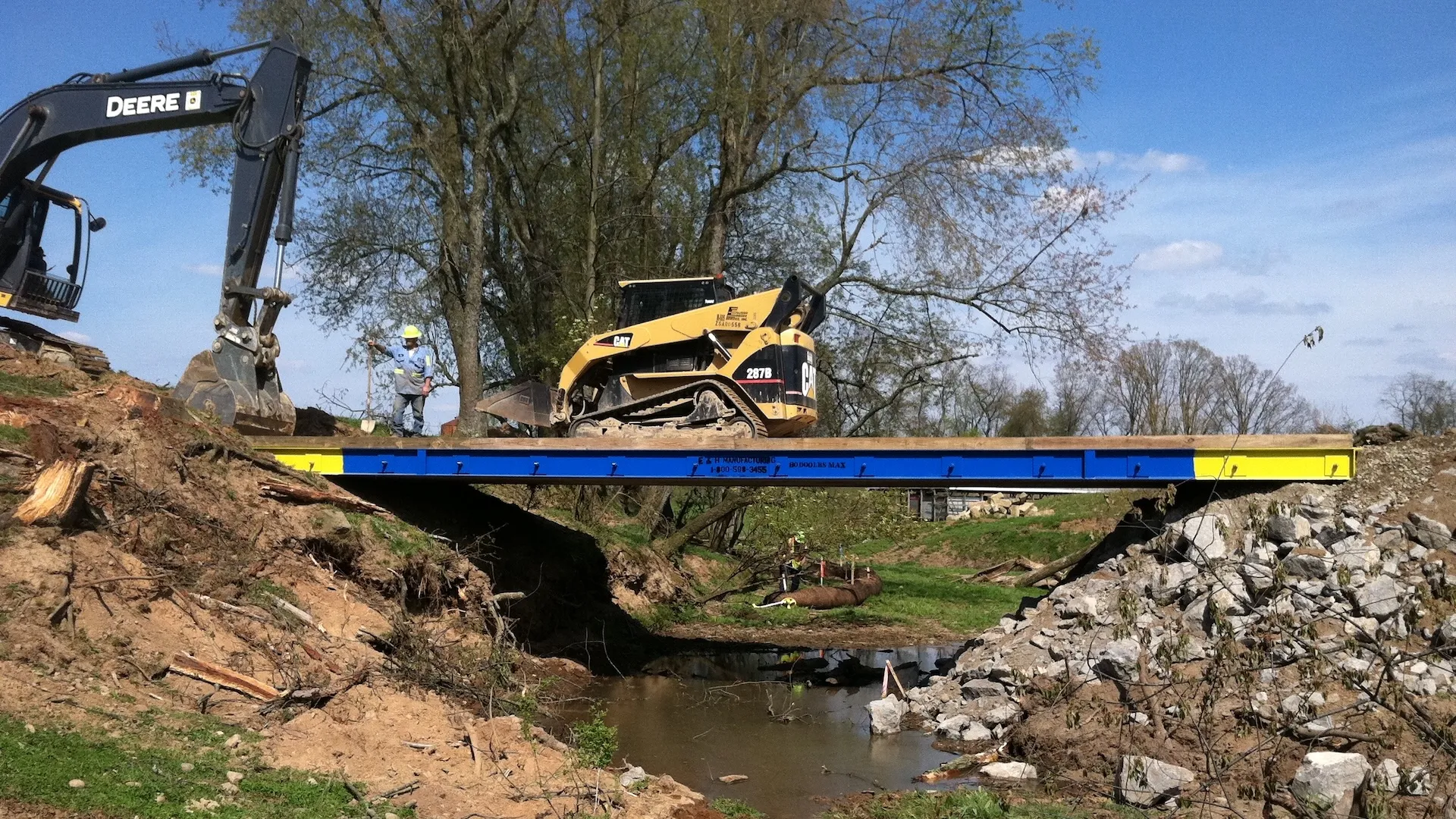

Skid steer crossing bridge during installation
Your Crew Sets It

Unload and position with a backhoe, excavator, or skidder. Slide the panels together, bolt the connections, and attach the curbs. No crane needed.

4

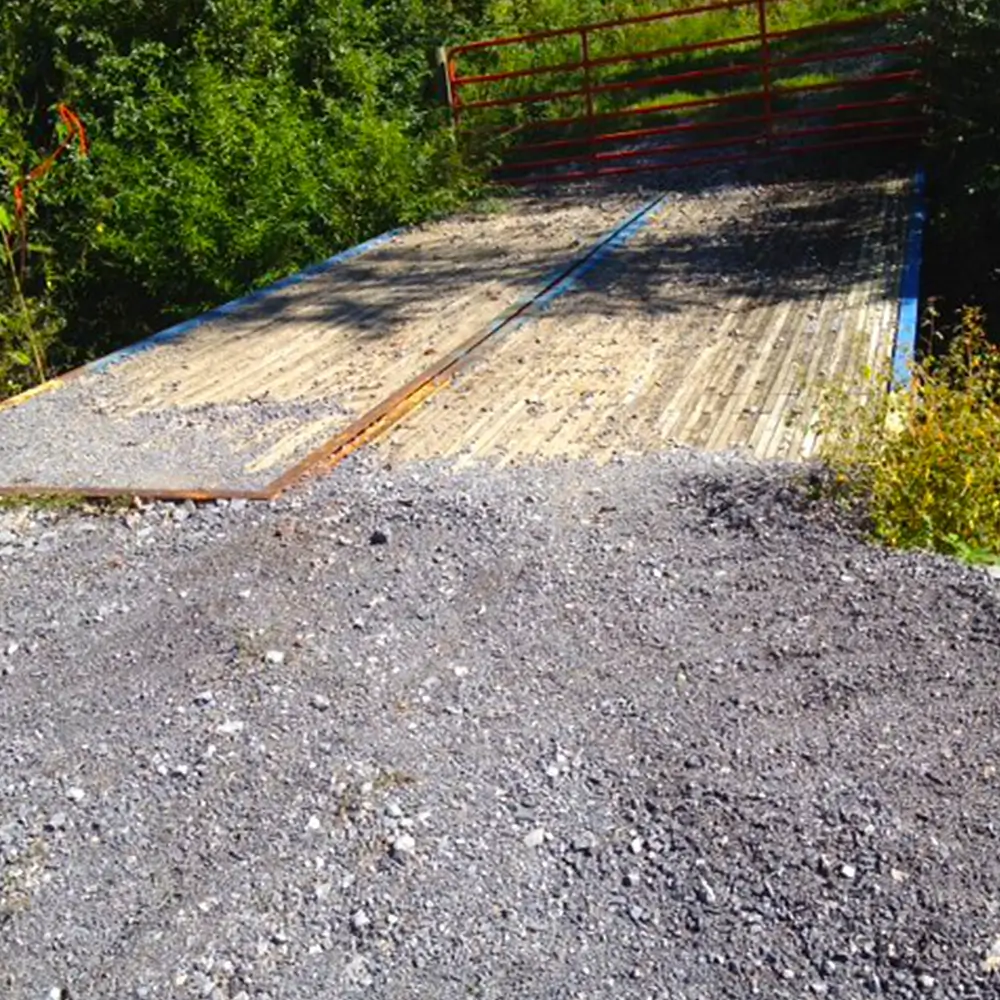

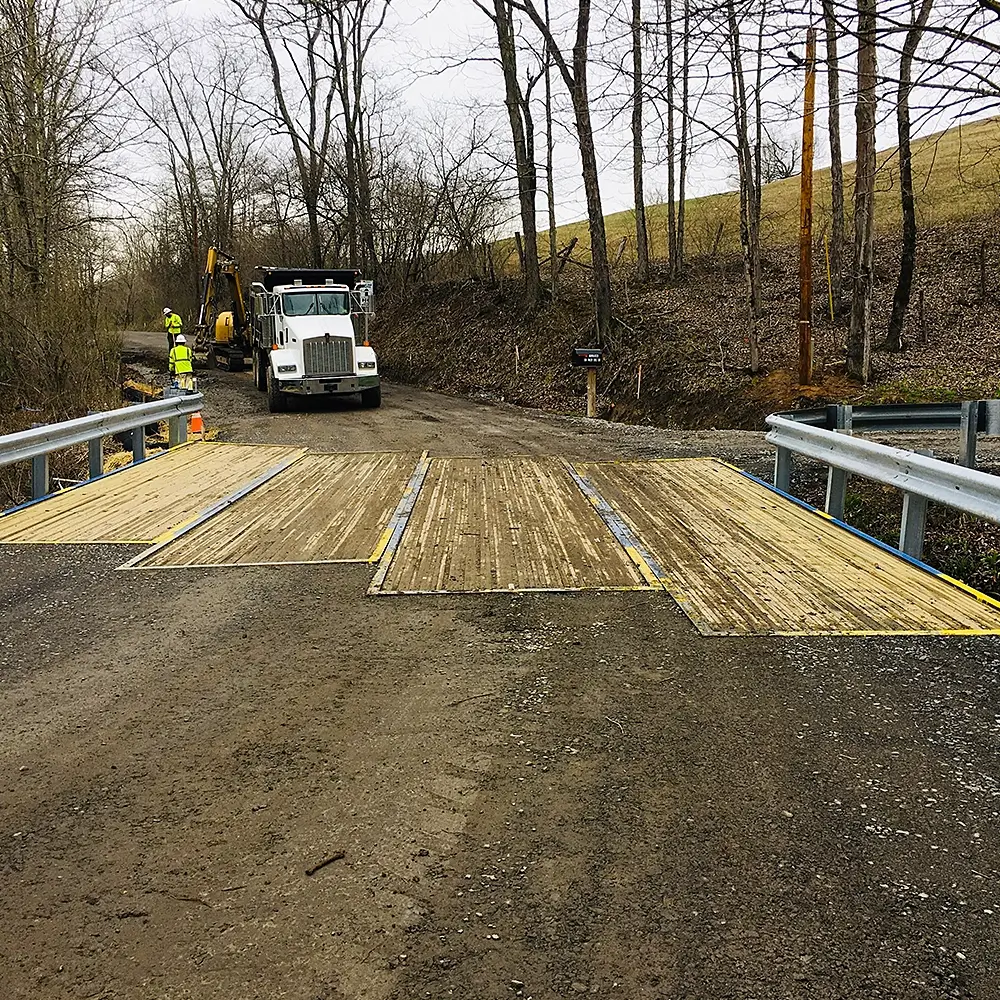

Finished bridge with truck crossing
You're Crossing

Drive across the same day. Rated for up to 80,000-lb multi-axle loads. Use it temporarily, relocate it when the job's done, or leave it in place permanently.

What makes a timber bridge carry 80,000 pounds?

The answer is stress lamination — a construction method where dozens of individual timber boards are set on edge, side by side, then compressed together by high-tensile stainless steel rods running through the entire cross-section. The rods are tightened to extreme tension, squeezing the boards so tightly that they behave as a single, unified structural slab.

Cross-Section View — Single Panel
6 ft 6 in (78 in)
Boards
Steel Channel
Stressing Rod
Hex Nuts
Bearing Plate
The key principle: The compression from the stressing rods creates enormous friction between every board. That friction is what gives the bridge its load-bearing capacity — not glue, not fasteners. The entire deck becomes a single structural element, and the surrounding steel channel frame adds impact protection and rigidity.
4
Lift points per panel
8–14
Stressing rods per panel
600 ft·lb
Min. rod torque specification

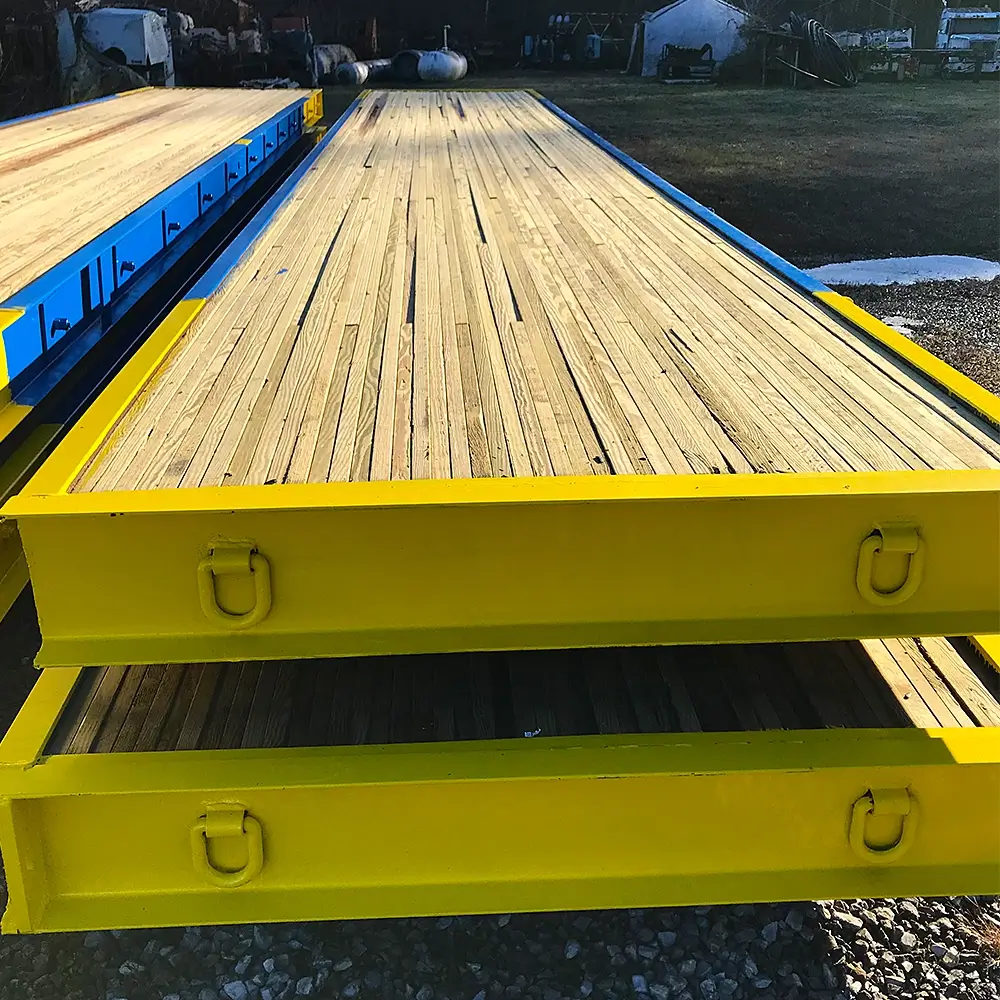

End view of stacked bridge panels showing timber laminations and steel channel frame

End view: individual laminations visible between the steel channel frame and D-ring lifting hardware

Completed bridge panel ready for delivery

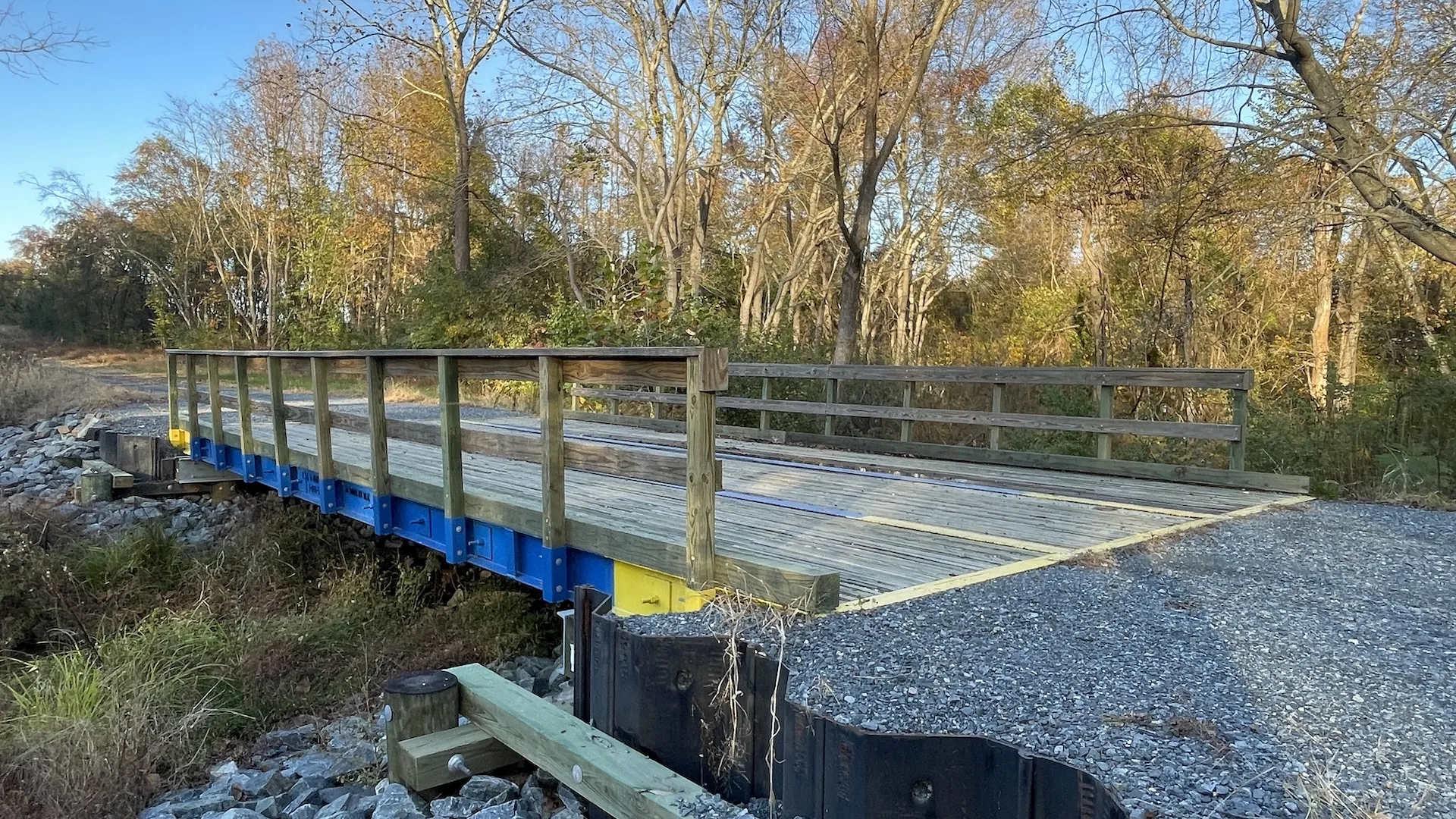

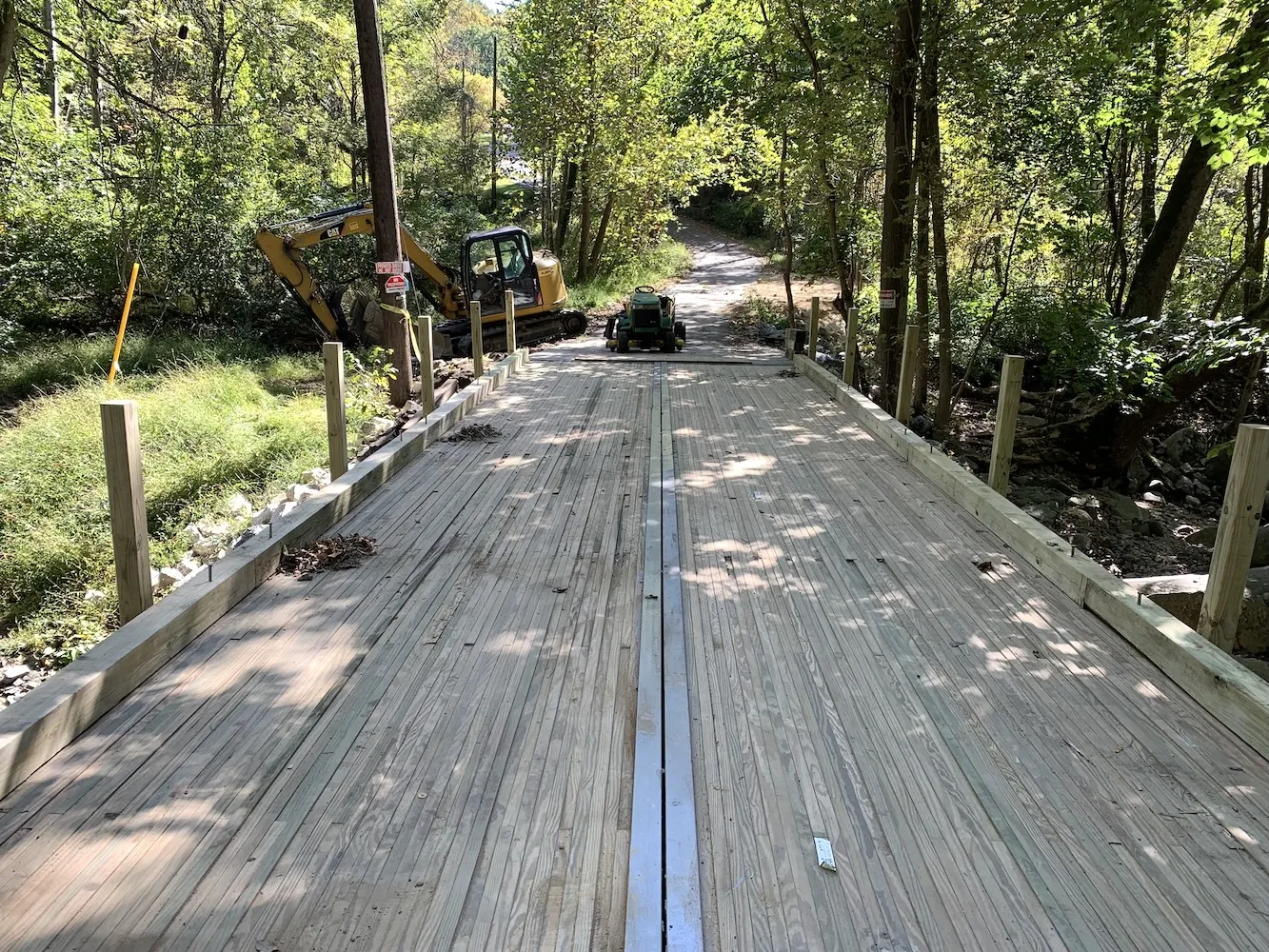

Installed timber bridge with guard rails Bridge approach in winter conditions Two bridge panels mated together at a stream crossing, viewed from the deck

Engineered for the loads you actually need to move.

Seven models across two lengths. Every bridge shares the same proven modular design: two 6'-6" panels, 13-ft assembled width, 12-ft drivable surface, steel channel reinforcement, and a patented shear-key mating system.

AASHTO HS-20 Load Rated

Top models meet highway-standard load ratings for full-size dump trucks, heavy equipment, and emergency vehicles.

Reusable & Relocatable

Remove, transport, and reinstall at a new site. These bridges are built as long-term capital assets, not one-time-use structures.

CCA-Treated Southern Yellow Pine

Kiln-dried after treatment for dimensional stability. Engineered to perform in wet, harsh, and environmentally sensitive conditions.

Bridge Models & Load Ratings
Model Length Clear Span Load Rating
SL30-06 30 ft 20 ft 38,000 lb
SL30-08 30 ft 20 ft 62,000 lb
SL30-10 30 ft 20 ft 80,000 lb
SL40-06 40 ft 30 ft 22,000 lb
SL40-08 40 ft 30 ft 36,000 lb
SL40-10 40 ft 30 ft 56,000 lb
SL40-12 40 ft 30 ft 80,000 lb

All models: 13-ft assembled width • 12-ft drivable surface • 5-ft min. bearing per end • Steel channel reinforced

Oil & Gas
Expand Energy (Chesapeake) • Arsenal Resources • Jay Bee Oil & Gas

Temporary stream crossings for well pad access, rig moves, and pipeline roads across Appalachian terrain. Low-impact and relocatable between sites.

Heavy Construction
Kelchner Inc • B&M Construction • Fox Engineering

Site access for excavation, highway work, and development projects. Move heavy equipment across streams and drainage without weeks of delay.

Utilities & Pipeline
Dominion Energy • B.R.S. Inc • Glen Johnston Inc

Access for transmission lines, underground utilities, and maintenance corridors. Install over waterways without in-stream disturbance.

Renewable Energy
Discovery Wind & Solar Energy

Equipment access for utility-scale solar and wind farms built on greenfield rural sites where stream crossings are unavoidable.

Municipal & Institutional
City of Raleigh • University of Kentucky

Permanent crossings for parks, greenway trails, campus utility corridors, and stormwater infrastructure that blend with natural settings.

Conservation & Land Management
EQR • McHenry County • NYC Watersheds

Low-impact crossings for ecological restoration, conservation access, and trail networks in environmentally sensitive riparian areas.

Watch a bridge panel come together.

Every bridge is fabricated at our facility in West Virginia. Stress-laminated timber. Structural steel channel. Load-tested before it ever leaves the shop.

  • No on-site fabrication — arrives ready to install
  • Standard excavating equipment handles placement
  • Patented shear-key system locks panels together
  • Relocate and reuse — it's a long-term asset
  • Optional guard rails, portable abutments, and accessories

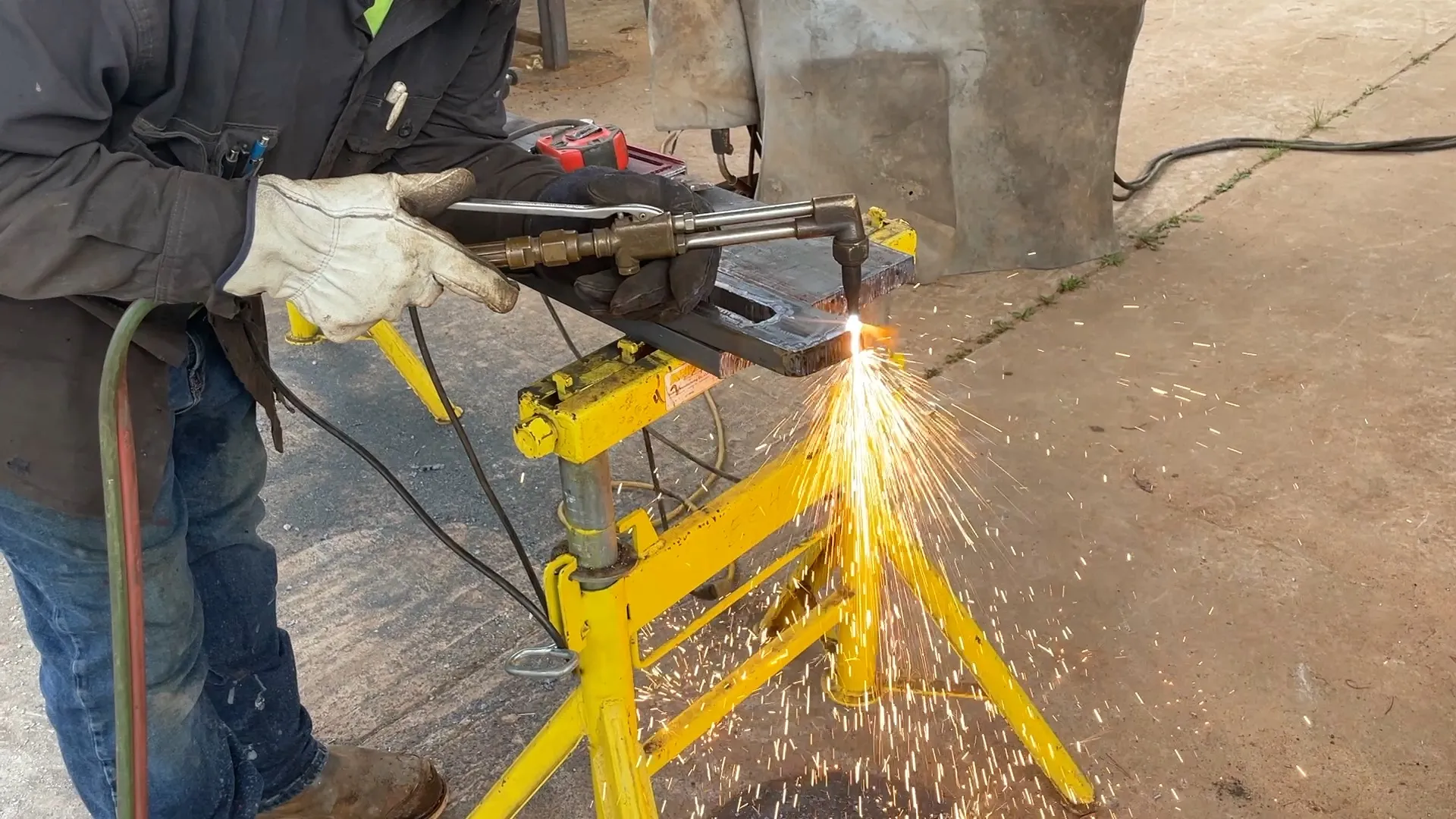

Steel fabrication — cutting structural channel with a torch

Serious engineering for serious work.

These aren't temporary mats or makeshift crossings. Every bridge is a pre-engineered structural system — #1 Grade southern yellow pine, stress-laminated with high-tensile stainless steel rods, encased in structural steel channel. The result is a unified deck that carries highway-rated loads across spans up to 30 feet.

Deck Material
CCA-treated, kiln-dried #1 Southern Yellow Pine
Reinforcement
Structural A36 steel channel perimeter frame
Stressing System
High-tensile stainless steel threaded rods
Connection
Patented shear-key & channel interlocking system

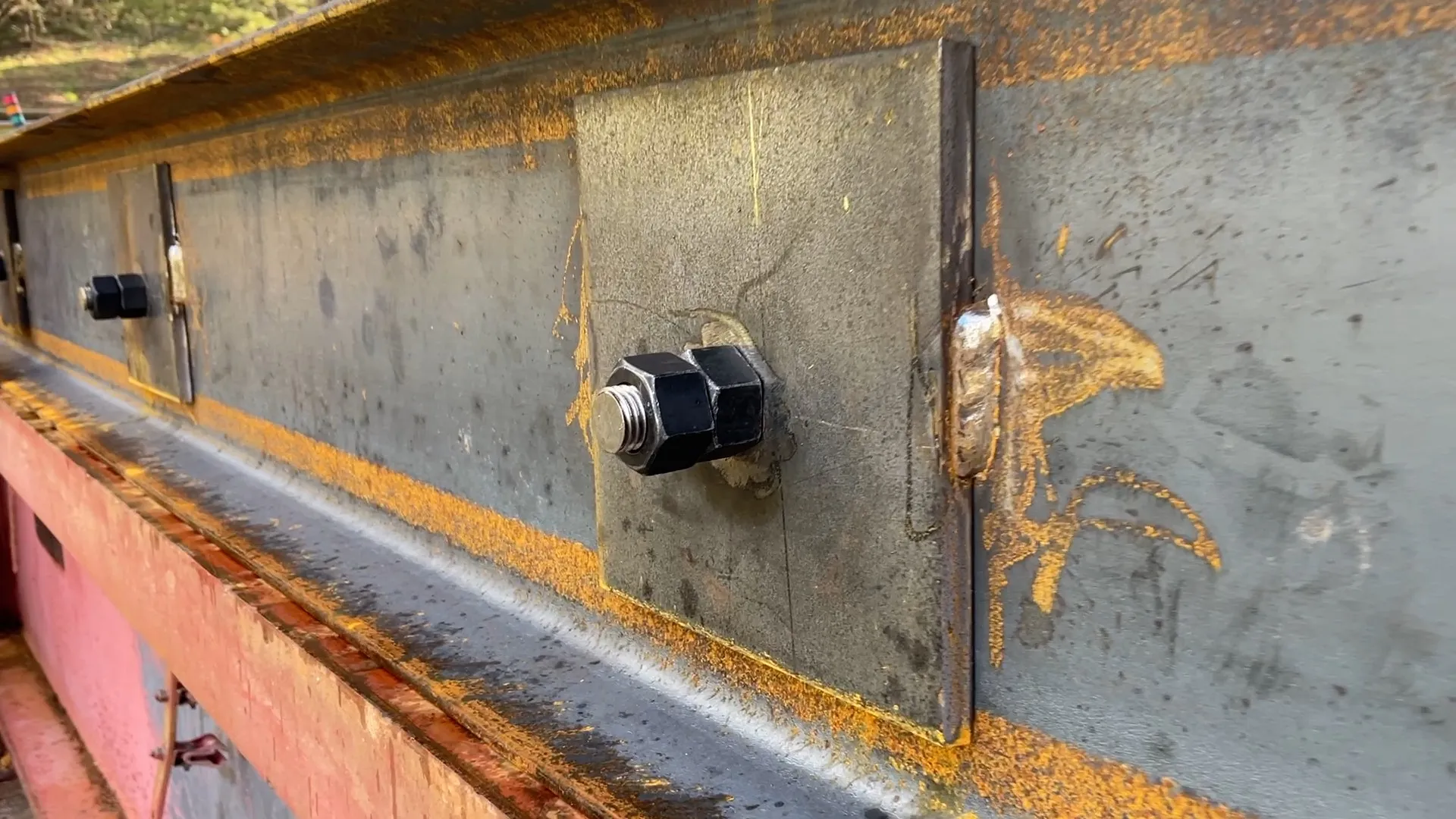

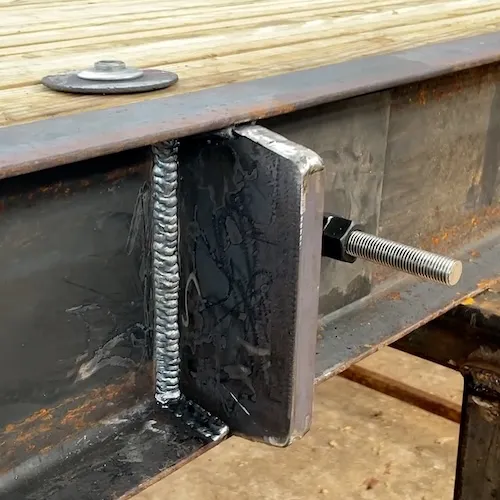

Bridge panel detail showing steel channel and lifting hardware Steel channel and stressing rod bearing plate Welded shear-key connection plate on steel channel

Tell us about your crossing.

Whether you need a temporary crossing for a six-month project or a permanent installation for decades of service, we'll help you find the right bridge for the job. Most inquiries get a response within one business day.

Call Direct
Location
Charleston, West Virginia
Request a Quote
We typically respond within one business day.
